Quick Connect: OAL Subsea Pipeline Completed

Friday, March 1, 2024

Making a twist on the proverb 'necessity is the mother of invention', GASCADE Gastransport GmbH and StreamTec Solutions AG completed the Ostsee Anbindungsleitung (OAL) subsea pipeline connecting the Mukran LNG terminal to the German energy grid at Lubmin in 18 months, a amazingly short turnaround considering the time frame encompassed project conception, design, permitting and construction.

The 'necessity' in this case: energy security for Germany and Europe.

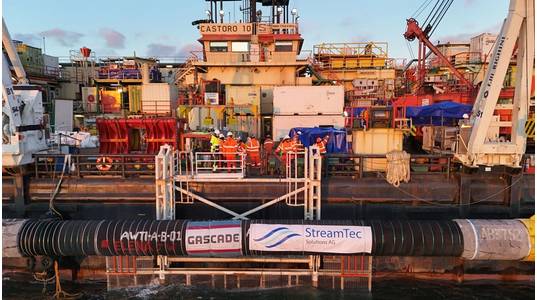

The OAL, mechanically completed in January 2024, includes a 50 km, 1.2m diameter offshore pipeline, two landfalls through micro tunnels and connections to two Floating Storage and Regasification Units (FSRUs).

Project Highlights:

  • Multi-party Contracting: Contract strategy moved away from the conventional 'EPC' (Engineering, Procurement, and Construction) frameworks, instead assigning StreamTec as PMC with direct oversight and coordination of more than 60 contractors. This approach enabled an early utilisation of the resources for the engineering and construction phases.
  • Parallel activities: StreamTec Solutions’ flat and efficient organization allowed the integration of engineering, surveying, permitting, procurement, materials supply and construction, transforming these into highly integrated and parallel activities.
  • Simultaneous Construction: coordination of over 50 vessels working simultaneously along the pipeline route, ensuring minimal downtime for the dredging, survey, and pipe-laying fleets.
  • Efficient Permitting and Collaboration: GASACDE and StreamTec’s expertise ensured timely permitting, crucial for the project's ambitious timeline. The project's flat organisational structure enabled swift decision making.
  • Future-Proof Infrastructure: beyond enhancing LNG supply, the pipeline is designed for future hydrogen transport, aligning with European green energy goals.


Categories: Technology Contracts LNG Offshore Energy Subsea Pipelines FLNG Subsea Pipelines

Related Stories

Eni-Petronas Gas Joint Venture Up for Launch in 2026

MDL Secures Cable Laying Job in Asia Pacific

Brownfield Output Decline Accelerates, says IEA

Aquaterra Energy Nets Subsea Analysis Contracts with INPEX off Indonesia

Chinese Contractor Secures Offshore Oil and Gas ‘Mega Deal’ from QatarEnergy

Floating Offshore Wind Test Center Planned for Japan

Synergy Marine Group Completes Conversion of LNG Vessel to FSRU

Saipem Wins FEED Contract For Abadi LNG Project FPSO Module In Indonesia

Inpex Picks FEED Contractors for Abadi LNG Onshore Plant

CNOOC Finds Oil and Gas in South China Sea

Current News

ABL Secures Rig Moving Assignment with India's ONGC

Pakistan, Türkiye Deepen Oil and Gas Ties with Offshore Indus-C Block Deal

Eni-Petronas Gas Joint Venture Up for Launch in 2026

Vietsovpetro Brings BK-24 Oil Platform Online Two Months Early

Propane’s Economic Edge for Ports During Trade Uncertainty

Shell’s Brazil-Bound FPSO Starts Taking Shape

Ventura Offshore’s Semi-Sub Rig to Keep Drilling for Eni in Asia

SBM Offshore, SLB to Optimize FPSO Performance Using AI

MODEC Ramps Up Hammerhead FPSO Work After ExxonMobil's Go-Ahead

Aesen, DOC JV Targets Subsea Cable Logistics

Subscribe for AOG Digital E‑News

AOG Digital E-News is the subsea industry's largest circulation and most authoritative ENews Service, delivered to your Email three times per week

https://accounts.newwavemedia.com
